Blog

  • The Impact Of Semiconductor Equipment Shortage On Roadmap

    Image Generated Using 4o


    What Is Happening?

    The semiconductor industry has always grappled grappling with a persistent and intensifying equipment shortage. What began as a supply chain issue has now become a long-term structural constraint.

    Lead times for advanced manufacturing tools, particularly those essential for next-generation process nodes, have extended to 12 to 18 months or more. At the same time, even equipment supporting mature technologies, such as 200 mm wafer processing, is experiencing delays.

    This highlights the broad and systemic nature of the problem.


    Why Equipment Shortage Becomes A Big Deal?

    Semiconductor manufacturing is deeply dependent on a highly specialized class of equipment. Unlike general-purpose tools, these machines are purpose-built, node-specific, and often come from a limited number of suppliers.

    When lead times stretch or tool availability drops, it directly impacts the ability of fabs to maintain their roadmap, yield, quality, and, ultimately, time-to-market. In short, the flow of innovation slows down not due to a lack of design capability but due to the absence of critical hardware.

    Furthermore, the complexity of modern fabs exacerbates this challenge. A high-volume production line for advanced nodes may require more than hundreds of different tools across lithography, etch, deposition, metrology, CMP, and packaging.

    These tools are not interchangeable and must be qualified together to maintain process integrity. When even one tool is delayed, it can stall an entire line, creating cascading effects across production schedules, R&D timelines, and customer commitments.

    Let us take a look at the key reasons why equipment shortage disrupts semiconductor manufacturing:

    AspectImpact Due To Shortage
    Tool ComplexityAdvanced tools require long design and qualification cycles. Shortages cannot be solved quickly.
    Limited SuppliersMany equipment types are produced by only one or two vendors globally.
    Node-Specific DependencyTools are tightly coupled with process nodes. Older tools cannot support new technology nodes.
    Qualification TimeTool installation is not enough, process tuning and validation take months.
    Cascade DelaysDelay of one tool stalls entire production flow, affecting capacity and delivery.
    Capital InflexibilityTool purchases involve long-term planning and capital allocation. Reacting fast is difficult.
    Customer CommitmentsOEMs cannot meet chip demand, leading to missed product launch windows.

    Eventually, with so much at stake, the absence of even a single critical tool can delay an entire roadmap, impacting everything from process migration to end-product delivery in data centers, smartphones, the automotive industry, and beyond.


    How It Impacts Process To Product Roadmaps?

    In the semiconductor industry, process development and product introduction are tightly interlinked. The process defines the physical capability. The product determines the commercial outcome. When equipment is delayed, both timelines are disrupted, affecting yield learning, PDK maturity, product qualification, and volume scalability.

    A shortage of critical tools delays the start of process integration, slows down line bring-up, and reduces wafer availability for early silicon validation. This means that design teams working on cutting-edge products cannot access silicon when expected, pushing out verification cycles, delaying firmware and software stack development, and ultimately affecting go-to-market-to-market schedules.

    Roadmap PhaseDisruption Due to Equipment Shortage
    Process Development (RnD)Inability to start integration due to missing litho/metrology/etch tools.
    PDK ReleaseDelays in baseline silicon characterization slow down PDK delivery to design teams.
    First Silicon AvailabilityFewer tools → fewer wafers → delays in prototype chips.
    Design Verification And DebugLack of wafers hampers test chip data collection and corner validation.
    Yield LearningLimited data slows defect analysis, process tuning, and model refinement.
    Ramp To ProductionLine qualification cannot proceed on schedule, impacting customer commitments.
    Customer Product RoadmapsEnd customers delay their platform or system-level releases due to unavailable chips.

    From a strategic standpoint, roadmap slippage caused by tool shortages has become a defining bottleneck. In the past, product schedules were gated by design complexity or mask cycle time.

    Today, it is common to see entire process families stalled at 90 or 95 percent readiness, waiting not on tape-out but on tool delivery, installation, and qualification. This shift redefines time-to-market planning across the industry.


    What To Expect And How To Mitigate Equipment Cycle Time Impact?

    The semiconductor industry should expect prolonged equipment lead times well into 2026, driven by persistent supply constraints, including a constant increase in demand for high-tech processes using advanced computing solutions for new-age workloads. Even with record levels of capital investment, manufacturing capacity at the equipment level cannot scale instantly.

    This creates a new normal where tool delivery timelines must be considered a core constraint in both process development and product planning. The traditional assumption that capital expenditure translates directly into immediate equipment availability is no longer valid.

    To mitigate this impact, companies should adopt a mix of strategic and operational responses. These include placing multi-year tool orders, pre-qualifying process steps across multiple sites, and using virtual process modeling to reduce dependency on physical wafers in early development.

    Most critically, close alignment between fab teams and end customers will be essential, ensuring that roadmap changes driven by equipment constraints are communicated and absorbed early in the product planning cycle.


  • The Productization Cycle Time In Semiconductor Development

    Image Generated Using 4o


    What Is Semiconductor Productization Cycle Time?

    Semiconductor productization cycle time refers to the total duration required to transform a completed chip design into a fully qualified, production-ready product. It begins after the design is taped out and ends when the product is released to high-volume manufacturing with acceptable yield, quality, and system-level reliability. This period involves intensive cross-functional collaboration across silicon engineering, packaging, test development, validation, reliability, and supply chain.

    The cycle is not a single step but a structured series of technical handoffs, optimizations, and problem-solving phases. Each contributes to overall time-to-market and has a direct impact on cost, quality, and revenue generation.

    The key components of the productization cycle include:

    • Tapeout to first silicon readiness
    • Initial bring up and functional debug
    • ATE test program development and correlation
    • Package and assembly qualification
    • Reliability and standards-based qualification testing
    • Yield analysis and production ramp
    • Customer validation and system integration feedback

    Depending on the complexity of the product and the target market, this cycle can range from six months to over a year. Shortening the cycle without compromising quality is often a strategic priority, especially in competitive or regulated markets.

    In the long-term, managing this time effectively is what differentiates strong product execution from delayed or over-budget programs.


    Typical Timeline Of The Productization Cycle

    The productization cycle consists of several tightly coupled stages. Each stage has its own objectives, deliverables, and potential bottlenecks. While exact timelines vary depending on product complexity, market segment, and technology node, the typical range for a complete cycle is six to twelve months.

    The timeline below outlines each primary phase, its expected duration, and the core activities associated with it.

    StageEstimated DurationKey Activities
    First Silicon Readiness4 to 6 weeksTapeout to wafer delivery, packaging for evaluation
    Silicon Bringup2 to 6 weeksBasic functionality, register access, debug loops
    Test Program Development8 to 12 weeksATE pattern creation, DFT validation, test coverage
    Package Assembly4 to 6 weeksSubstrate readiness, thermal and form factor checks
    Reliability Qualification6 to 12 weeksHTOL, HAST, Temp Cycle, ESD, latch-up tests
    Yield Ramp and Optimization8 to 16 weeksProcess tuning, guardband validation, corner lots
    Customer Validation4 to 8 weeksApplication-level tests, system integration

    In many cases, some stages run in parallel to save time. For example, reliability testing and test program optimization may proceed concurrently after bringup. However, any failure in these parallel flows can lead to rework, which resets the clock for the affected stage.

    Thus, efficient productization requires not only strong technical execution but also program-level coordination to ensure each stage feeds smoothly into the next. Such a structure becomes even more critical when managing tape-outs across multiple products or process nodes.


    What Drives Productization Delays

    Delays in the productization cycle are common due to the technical complexity and cross-functional nature of semiconductor development. Common causes of delay include:

    • Incomplete Pre-Silicon Validation: Simulation fails to capture real-world corner cases that emerge only during bring-up
    • DFT and ATE Mismatch: Poor alignment between design-for-test features and test platform implementation slows test development
    • Packaging Issues: Packages may face late-stage problems with thermal, mechanical, or signal integrity
    • Qualification Failures: Reliability tests, such as HTOL or HAST, can fail, requiring debugging and retesting cycles
    • Yield Instability: Low or inconsistent yield across corners demands additional tuning and analysis
    • System-Level Gaps: Customer-side failures frequently result in late changes to silicon or test programs

    Even with detailed planning, issues often emerge from immature designs, process variability, and misaligned engineering handoffs.


    How Cycle Time Impacts Cost

    The productization cycle time has a direct impact on development costs. Each added week increases engineering effort, lab usage, and the need for additional silicon or packaging builds.

    These costs rise rapidly, especially for complex System-on-Chip (SoC) designs or high-reliability products. These longer cycles also stretch budgets and delay production, reducing the time available to recover investment.

    Delays also create opportunity costs. Missing key market windows or customer ramps can result in lost sales opportunities, lower selling prices, or even canceled projects.

    Underutilized equipment and late delivery in regulated markets may also trigger penalties. Managing cycle time effectively is essential for both technical execution and business success.


    Strategies To Optimize Productization Time

    Reducing productization cycle time requires more than just faster execution. It requires a structured, cross-functional approach that addresses bottlenecks, enhances handoff efficiency, and anticipates familiar sources of delay. Leading semiconductor companies treat productization as a tightly managed engineering flow, where technical readiness is synchronized with program planning and customer engagement. By front-loading risk and parallelizing key activities, teams can compress timelines without sacrificing quality or reliability.

    Below are the strategies to optimize productization time include:

    StrategyDescription
    Early Test DevelopmentBegin ATE pattern development and validation before first silicon using virtual test setups and simulations.
    First-Time-Right Design CultureEmphasize high-quality closure throughout the design cycle using linting, static checks, and sign-off tools to reduce post-silicon issues.
    Cross-Functional OwnershipAssign dedicated ownership early in the cycle to coordinate activities across design, test, validation, packaging, and customer engagement.
    Parallel Qualification and DebugRun reliability testing and test debug in parallel with early silicon to minimize serial dependencies.
    Unified Pre and Post-Silicon FlowAlign pre-silicon simulation environments with production test platforms to improve correlation and reduce transition time.
    Strong Data InfrastructureUse analytics tools for yield, failure analysis, and traceability to support faster debugging and feedback.
    Supplier and Customer IntegrationEngage OSATs, substrate vendors, and customers early to align requirements, timelines, and failure response plans.

    When these strategies are executed with discipline and data-driven feedback loops, teams can reduce cycle time significantly while improving first-pass success rates.

    Eventually, the result is not only faster product release but also greater cost control and more substantial customer confidence.

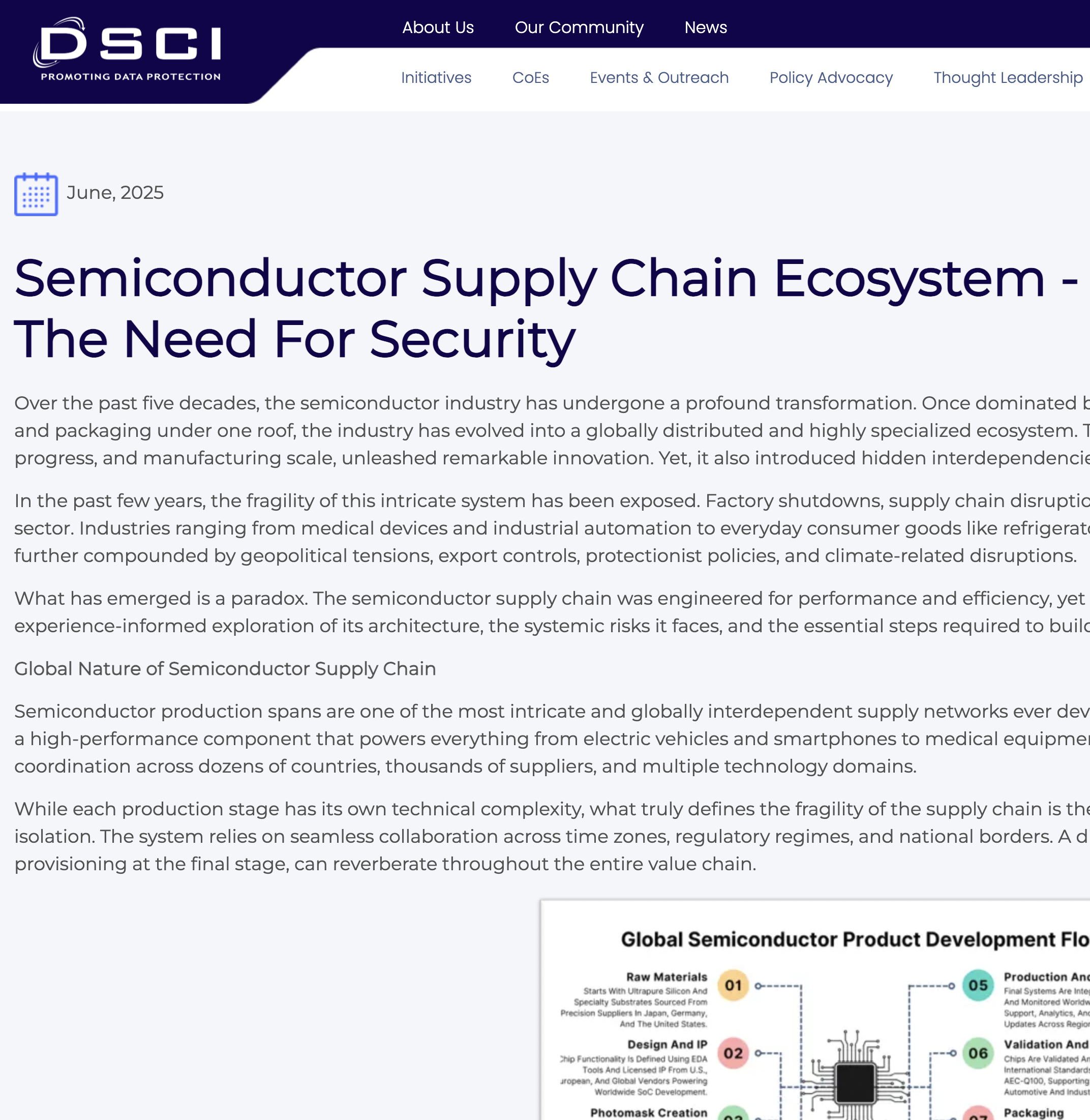

  • Semiconductor Supply Chain Ecosystem – Complexity, Risks, And The Need For Security

    Published By: Data Security Council of India
    Date: June 2025
    Media Type: Online Media Website

  • The Semiconductor ASIC Versus SoC Design Reality On A Post-Moore World

    Image Generated Using 4o


    What ASIC And SoC Actually Mean Today

    An ASIC was a fixed-function chip logic designed from scratch, optimized for area, power, and speed, and then locked down. It worked particularly well for high-volume products, where every bit of efficiency mattered.

    A System-On-A-Chip (SoC) integrates multiple functions, including CPU, memory controllers, accelerators, and I/Os, using pre-verified IP blocks. It reduced design time but gave up some control.

    The question is no longer “Is it an ASIC or SoC?” It is:

    • How much of it is reused?
    • How configurable is it?
    • How much control do you have?
    • Can team handle the integration and bring it up to speed?

    That line is now blurred. Most ASICs use third-party IPs. Some System-On-A-Chip (SoC) devices are heavily customized for specific applications. And hybrids, such as semi-custom SoCs and chiplet-based designs, mix both worlds.


    Design Tradeoffs: Cost, Time, And Risk

    The core difference between ASIC and SoC design is not technical. It is about tradeoffs. Engineering teams rarely get unlimited time, budget, or people. Every decision shifts pressure to another part of the process, resulting in more integration, extended verification, higher costs, or added schedule risk.

    ASICs and SoCs have different profiles in terms of cost structure, development time, silicon risk, and maintainability. These factors are not always apparent at the outset, especially when decision-makers prioritize performance or BOM reduction.

    The table below outlines the practical differences most teams encounter:

    FactorASIC DesignSoC Design
    Development Cost (NRE)High — Full RTL, physical design, verificationModerate — Uses licensed IPs and reference subsystems
    Licensing CostLow — Mostly in-house logicHigh — Paid IP cores (CPU, GPU, I/O, etc.)
    Time to MarketLong — Custom design and verification cycleShorter — Integration-focused, often platform-based
    Performance TuningHigh — Full control over timing and layoutLimited — IP black-box behavior restricts optimization
    Verification LoadFocused — Single-purpose, scoped verificationHeavy — Complex IP interactions and corner cases
    Risk of Re-spinHigh — Full custom logic, harder to catch bugsMedium — IP is usually well-tested but integration is risky
    Volume SuitabilityHigh — Payback improves with high unitsGood — Better for mid-volume or evolving product lines
    Design ReuseLow — Hard to adapt without major reworkHigh — Easier to reuse across multiple designs
    Team Skill RequirementAdvanced — Needs strong physical + logic teamMixed — Strong integration and system-level thinking
    Tooling/EDA DependencyHeavy — Full flow needed (RTL to GDSII)Shared — Platform vendors often provide part of toolchain

    Many teams attempt to strike a balance between the two, utilizing ASIC methodology for the core logic and incorporating SoC-style IP blocks around it. The key is not just choosing a design model but also knowing what your team can realistically deliver, verify, and provide production support for. Cost, time, and risk are always connected, improving one usually stresses the others.


    Post-Moore Constraints Are Changing The Game

    Shrinking nodes no longer guarantee better power, area, or speed. At 5nm and below, power density, interconnect delay, and thermal issues dominate. Routing is more challenging, and physical limits, such as variation and IR drop, can hinder performance gains.

    For ASICs, even finely tuned blocks now face yield and manufacturability challenges. Full-custom is harder to justify unless volumes are high. Teams increasingly rely on hardened IPs and foundry-guided flows to stay within constraints.

    SoCs handle this better through the reuse of mature IP blocks, stable interconnects, and known thermal profiles, thereby reducing risk. However, flexibility is limited. You cannot continually optimize data paths or packaging to fit specific system needs.

    In the post-Moore era, design is now more about managing limits than pushing specs. What matters is not what performs best in theory but what yields, scales, and ships reliably.


    Choose What You Can Sustain, Not Just What You Can Build

    The ASIC vs SoC decision is less about architecture and more about lifecycle cost, verification effort, and team maturity. If your design requires tight control over timing, power, or area and you have the resources to manage full RTL ownership, physical implementation, and signoff, ASIC can make sense.

    But every decision is expensive to change. One late bug or corner-case miss can delay the tape out or force a re-spin.

    SoCs reduce that risk by leveraging proven IP and platform integration. You trade off flexibility for predictability. But even that path demands strong system validation skills, especially when IP vendors vary in quality, methodology, and update cadence.

    The fundamental constraint is not what you can design, but rather what you can verify, debug, yield, and support under actual time and budget pressure. In a post-Moore landscape defined by complexity, cost, and uncertainty, sustainable execution beats architectural ambition. Choose accordingly.

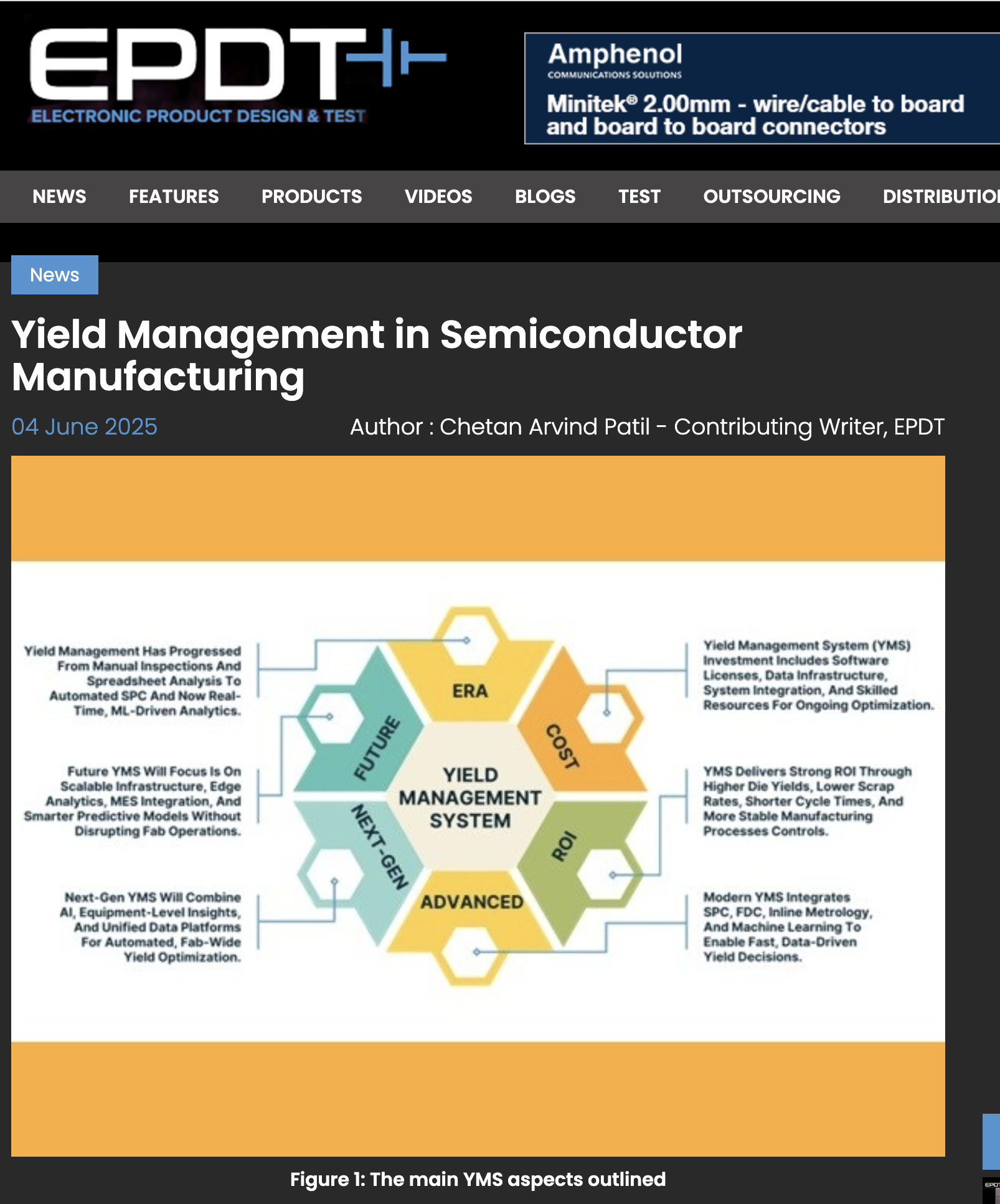

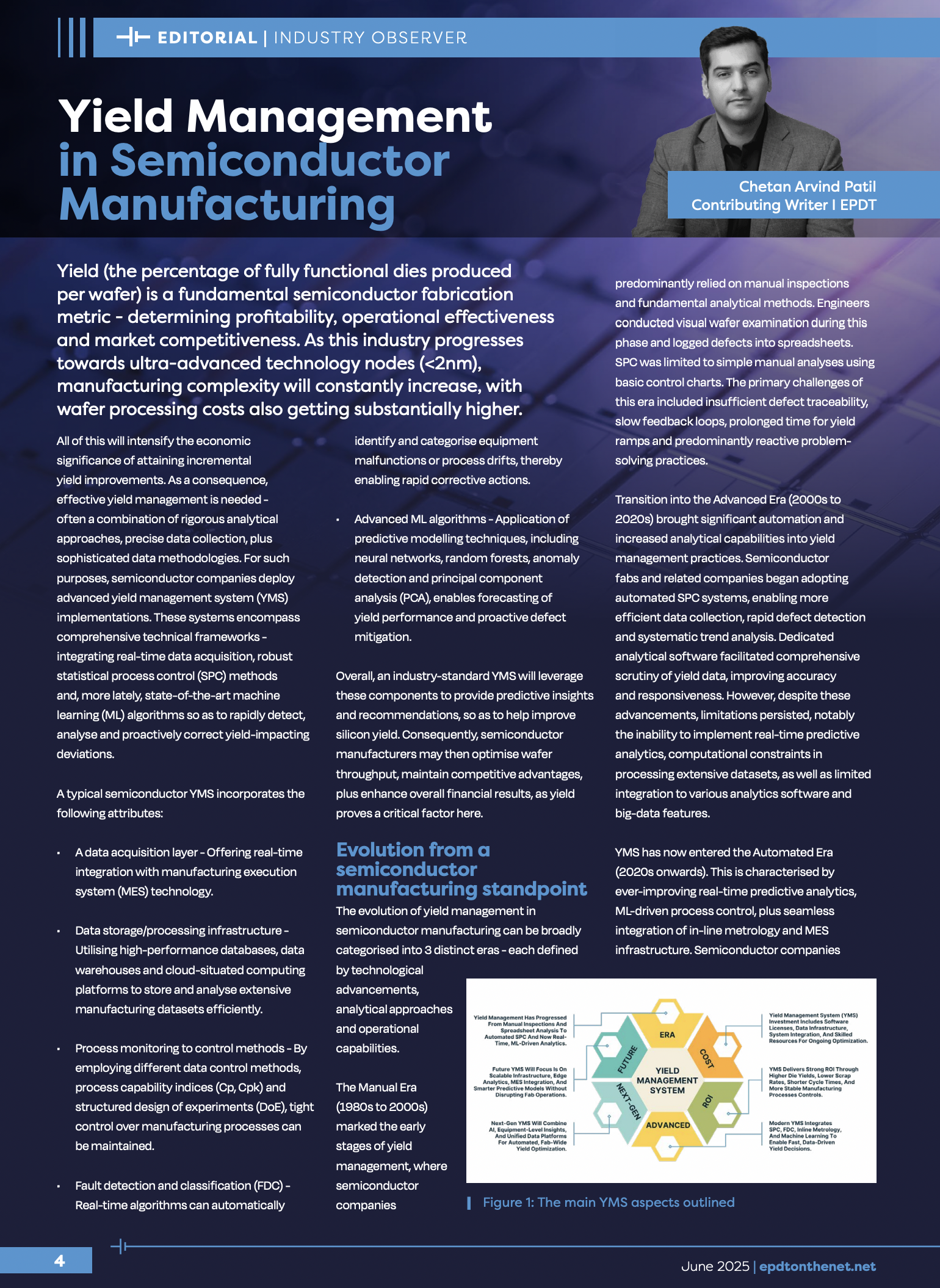

  • Yield Management In Semiconductor Manufacturing
